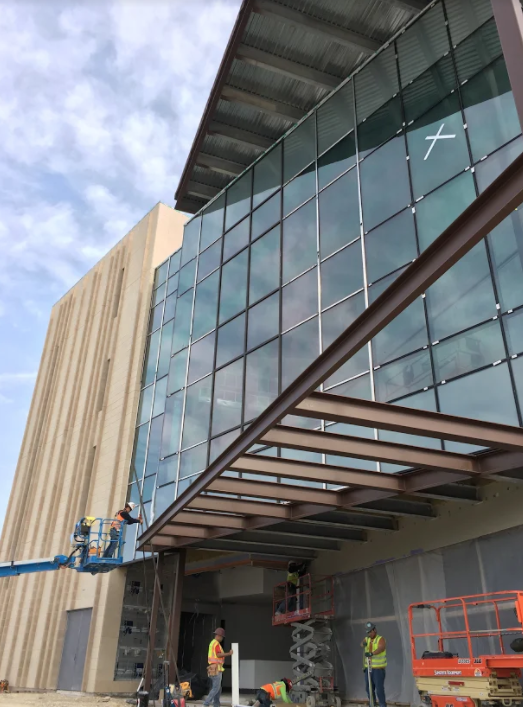

Installation of the wood ceiling grid commenced. Above ceiling work including the installation of fire sprinkler pipe, duct insulation, plumbing lines, vent/drain lines, chilled water piping and flushing, electrical conduit/boxes, and cable tray continued this month. Tape and float, block filler, primer, and paint at all three levels also continued.
The installation of access flooring at the ACCelerator commenced and is near completion. The installation of carpet flooring also commenced this month at the second and third floors east side. The installation of the traction elevator was completed.
